A stacked ICF wall weighs almost nothing. It is foam and plastic webs, light enough to carry by hand. A few hours later the same wall is full of wet concrete, which behaves like a liquid and pushes outward on every square inch it touches, harder the deeper it gets. Insulated concrete form bracing is what holds the line between those two states.

It is also the only chance you get to make the wall straight. Once the concrete sets, whatever shape the form was in is the shape of your foundation, permanently.

What the Bracing Actually Is

People picture a few boards nailed to the side of the wall. A proper alignment system is closer to a scaffold.

Nudura’s own Installation Manual (section 6.6, the Nudura Alignment System) lays the parts out plainly:

The manual has the system going on one side of the wall only, preferably the inside of the building, at 5 feet 4 inches on centre. The manual’s reason for that number is the planking overhead: it allows proper plank spacing and enough overlap. It also says to add braces on either side of every opening, and sometimes one in the middle of a wide one.

Why the Screws Are Left Loose

Here is the detail that tells you whether a crew understands the system. The manual calls for one screw per course into the channel, placed near the top of the slot and not overtightened. The forms have to be able to slide in that slot.

That sounds backwards until you see what the brace is for. It is not there to clamp the wall in one position. It is there to let you move the wall, with the turnbuckle, after it is loaded and before it sets.

The forms have to be free to move while they are filled and straightened. So the wall gets an initial check for plumb and straightness as the pour nears the top, and a final fine adjustment at the end, with string lines, a tape and a laser level, according to Nudura’s post-placement checklist. A wall that is braced rigidly cannot be corrected. A wall that is braced properly can, for exactly as long as the concrete stays plastic.

Where the Pressure Goes

The straight runs are the easy part. The bracing earns its keep at the places where a form is weaker or the pressure is higher, and the manual names them:

Inside the wall there is a quieter layer of bracing too. Nudura recommends a row of its Form-Lock in the second course and in every third or fourth course after that, specifically to keep the wall straight.

The Pour Rate Is Part of the Bracing

Bracing is rated for a load, and the load depends on how fast you fill the wall. The Nudura manual cites ACI 304 and CSA A23.1 for a placement rate of no more than 4 feet of lift per hour. On a gable end it goes further: slump comes down from the typical 6 inches to about 4, and on a steep slope lifts can drop from 4 feet to 2.

So when a crew goes around the whole perimeter in passes instead of filling one bay to the top, it is not being slow. It is keeping the pressure inside what the forms and braces were designed to hold. The pour day post covers what that looks like from the catwalk.

The Brace Is Also the Scaffold

The same steel carries the crew. That is the point of a combined system: the people placing and vibrating concrete are standing on the thing that holds the wall straight, at the height they need to be.

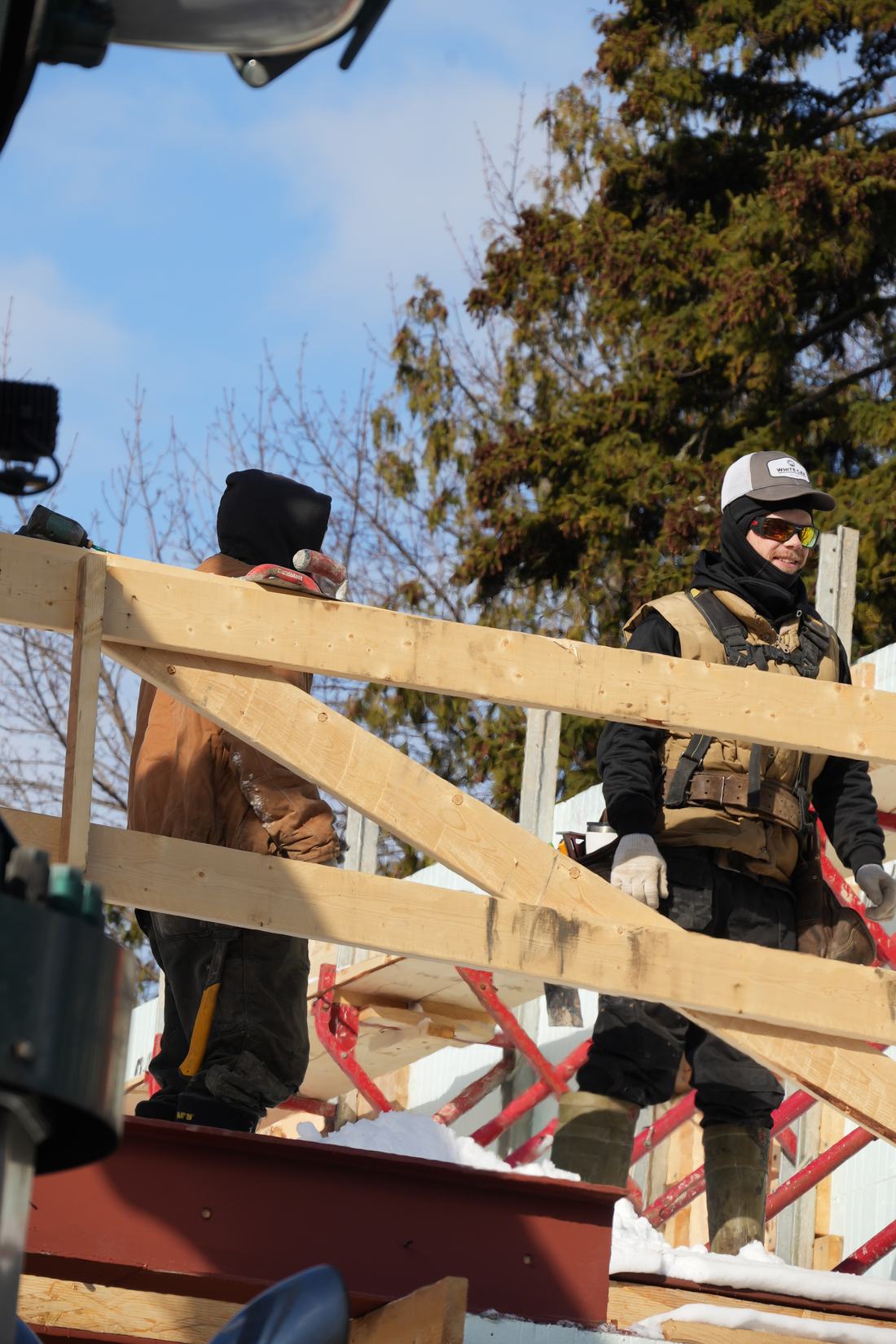

Two crew members on the bracing platform beside an ICF wall in winter, behind a timber guardrail
Up on the bracing on a winter ICF build. The platform the crew works from is part of the system that holds the wall.

It also sets a limit. Nudura states its system is designed for the weight of the workers, wind loads and the weight of the wall, and nothing else. Stack a pallet of material on the planks and you are loading the brace with something it was never sized for, on the one day it is already working hardest.

When It Comes Off

Not when the truck leaves. The manual says the alignment system stays on until the concrete has cured enough, or until the floor or roof system is in place to give the wall lateral support. If it comes off sooner, temporary bracing goes on.

For a foundation there is a second rule that matters more: no backfill until the concrete has cured and the subfloor is installed. The manual’s rule of thumb is about 40 per cent of design strength at three days, 60 per cent at seven, and full strength at 28.

The reason is the same reason the brace exists. Backfill pushes on the wall, and until the subfloor is in, there is nothing at the top of the wall pushing back. The brace holds the wall against the concrete. The floor is what holds it against the ground.

How We Brace a Wall

We run Giraffe bracing and alignment scaffold on every wall. It is a different maker from the system described above. The job it does is the same.

Our ICF foundations work is braced and aligned on that scaffold and checked at every lift, because every trade after us inherits whatever we leave behind. That is not a slogan. A wall that is out by half an inch becomes the framer’s problem, then the drywaller’s, then yours.

The concrete scope is ours, too. We self-perform the footings, the walls and the waterproofing rather than handing the part that decides everything above it to a rotating cast of subs. We are certified installers across the systems we build with, including Nudura, Amvic, Element and Fox, and our supply partners include Everything ICF, a specialty supplier of blocks, bracing and accessories.

If you have a foundation coming up, tell us about the project. The full below-grade scope is on our ICF foundations page.

FAQ

How far apart should ICF bracing be?

Follow the manufacturer of the block you are building with. Nudura’s Installation Manual puts its alignment system at 5 feet 4 inches on centre, with extra braces on either side of openings and, for a wide opening, one in the middle. If you are building with another system, use the spacing in its own manual.

Do you brace both sides of an ICF wall?

Not with the main alignment system. Nudura places it on one side only, preferably the inside of the building. Corners near openings, cut joints and T-walls get extra support on top of that, which can be outside the wall.

Can an ICF wall be straightened after the pour?

Only while the concrete is still plastic. That is what the turnbuckle on each brace is for: the crew makes a first check as the pour nears the top and a final fine adjustment at the end with string lines and a laser level. Once it sets, the wall is the shape it is.

How long does the bracing stay on?

Until the concrete has cured enough, or the floor is on and holding the top of the wall. On a foundation, backfill waits for both the cure and the subfloor. Nudura’s manual puts concrete at roughly 40 per cent of design strength at three days and full strength at 28.

What happens if an ICF wall is not braced properly?

In the mild case, the wall sets out of plumb or with a bow, and every trade after it spends money correcting something they did not cause. In the bad case, the form bulges or splits at a corner, a buck or a cut joint during the pour, with concrete already in it.
